Bypass, dewatering, water take, and treatment systems are often planned around one question – what equipment do we need?
On complex projects, that’s rarely enough.
A temporary setup may need to protect a live wastewater network, keep an excavation dry or treat discharge. If it fails, the result can be project delays, compliance risk, environmental harm or disruption to live infrastructure.
So, the more useful question is – what risks does this temporary setup need to manage?
Contents
- What should you consider before planning a bypass or dewatering setup?
- Why is redundancy important in temporary pumping and bypass systems?
- How does monitoring reduce project and compliance risk?
- When is water treatment needed before discharge?
- Design for the site – not just the flow
- What experienced project teams do differently
- Plan the system around the risk
- FAQs about temporary water and fluid systems
Key takeaways – Temporary systems at a glance
- Temporary systems can carry critical project risk.
- Planning should start with failure consequence – not pump size.
- Redundancy, alarms, monitoring and response need early planning.
- Discharge quality and consent requirements should be checked early.
- The right setup must work on paper and on site.
What should you consider before planning a bypass or dewatering setup?
Start by understanding the consequences of failure. Before selecting equipment, consider what happens if the bypass stops, inflow increases, discharge limits are exceeded or the site loses access. Also clarify:
- Who gets the alarm?
- Who responds?
- What the backup plan is?

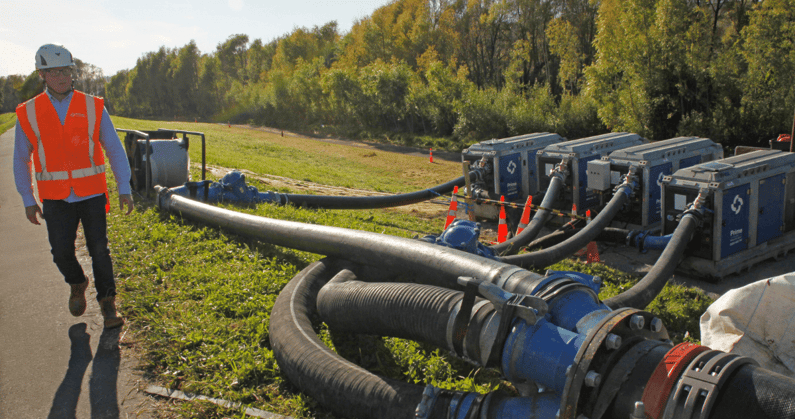

On live sewer bypasses, the temporary system effectively becomes the operating network. During Western Trunk works in Lower Hutt, a live sewer bypass had to manage peak wet-weather flows of around 350-400 litres per second – while relining continued on a critical trunk sewer near SH2 and the Hutt River.
“On a live bypass, redundancy has to be designed in. If a primary pump fails, the backup needs to start immediately – without stopping the pumping operation.”
Ben Beatson – Hire Account Manager, Prime Fluid Management

Western Trunk sewer bypass in Lower Hutt – with redundancy built in before flow was diverted
Why is redundancy important in temporary pumping and bypass systems?
Redundancy reduces failure risk by ensuring backup capacity is in place before the setup goes live. For high-risk bypass work, that may include:
- Backup pumps already connected
- Alarm systems and escalation paths
- Fuel or power contingency
- Remote monitoring
- Defined response procedures.
On Western Trunk, these measures were designed-in before flow was diverted.
How does monitoring reduce project and compliance risk?
Monitoring helps project teams identify issues early, stay within consent limits and respond before small problems become project delays.
On the Ōtaki to North of Levin (O2NL) project along SH1, water had to be transferred across a 24km corridor using multiple extraction points, pond transfers and consent-controlled water take.
“The distance was a big factor – but telemetry, pump controls and consent compliance were what made the project genuinely complex.”
Duncan Moore – Sales Engineer, Prime Fluid Management
The system checked stream flows, controlled pumping and maintained water for dust suppression. Effective monitoring shows whether:
- Teams are operating within consent limits
- Water storage is adequate
- Pumps are performing as expected
- Intervention is required.
When is water treatment needed before discharge?

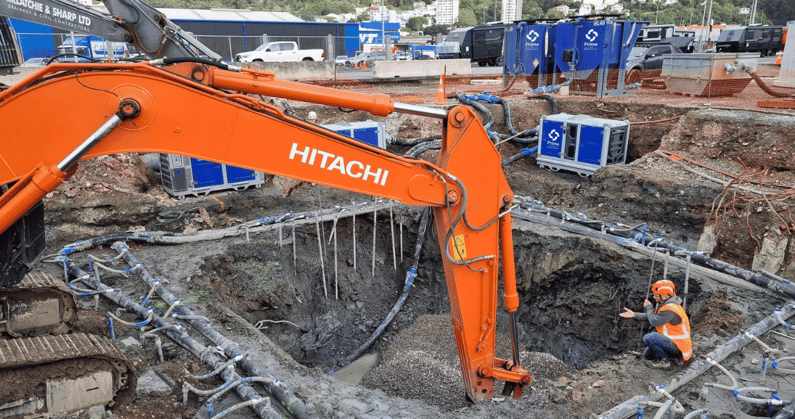

Treatment may be required when groundwater contains sediment, hydrocarbons, heavy metals or other contaminants that can’t be managed through settlement alone. At CentrePort in Wellington, dewatering and treatment had to work together. The site involved contaminated groundwater, hydrocarbons, sludge, tidal influence and strict discharge requirements. The job wasn’t just dewatering – it was managing groundwater and treatment as one system.

Dewatering and treatment working together at CentrePort – a constrained Wellington marine site
A recent Whangārei water polishing project presented a different challenge. Dissolved heavy metals called for treatment beyond conventional settlement, because the issue was in the water itself, not just suspended material.
“Not every discharge issue is a simple settling problem. If you think of heavy metals, you might expect them to drop out of the water – but when they’re dissolved, the treatment approach has to change.”
Ambrose Holt – Sales Engineer, Prime Fluid Management
Test early, understand the discharge limits and choose the treatment approach early.
Design for the site – not just the flow
A temporary system still has to work in real site conditions.
Pipe routes, treatment space, fuel access and changing conditions affect what’s practical. On constrained sites, pump capacity is only part of the decision.
What experienced project teams do differently
Experienced project teams think about temporary works earlier. They:
- Identify risks before selecting equipment
- Plan redundancy before the setup goes live
- Confirm discharge limits before water becomes a problem
- Understand who’ll operate, maintain and respond once it’s running.
Experienced teams scale the planning to the risk – so the system is as robust as the job requires.
Plan the system around the risk
Temporary works are often judged by what doesn’t happen. The bypass keeps running. The excavation stays dry. The discharge remains within limits. The programme keeps moving because risks were planned early. When a temporary system carries critical delivery risk, it needs the same level of planning as the permanent asset.

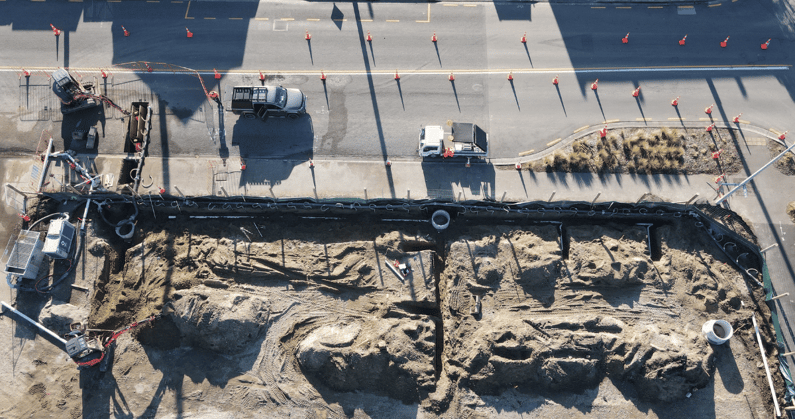

Tidal groundwater management during dewatering works in New Brighton
FAQs about temporary water and fluid systems
What should be considered when planning a temporary bypass or dewatering setup?
Start with the consequence of failure, expected flows, discharge limits, redundancy, monitoring, access and response planning. Find out what makes a temporary sewer bypass reliable.
Why can temporary pumping setups become critical to a project?
Because they may protect live infrastructure, keep excavations dry, maintain water supply or prevent non-compliant discharge.
What can go wrong if a temporary setup is under-planned?
The project can face delays, flooding, environmental risk, compliance breaches or disruption to live networks. Learn more about planning water management for complex civil projects.
When is water treatment needed before discharge?
Treatment may be needed when water contains sediment, hydrocarbons, heavy metals, contaminated groundwater or other consent-controlled contaminants. Discover how dissolved heavy metals were removed from storage pond water.
How does Prime help with temporary water and fluid works?
Prime helps plan and deliver bypass, dewatering, water take and treatment setups with redundancy, monitoring and site-ready design. Find out about Prime’s pump hire solutions.
